Quartz Countertop Procurement Risk Reduction Guide

— You are trusting a supplier with countertops for hundreds of apartments. What gives you confidence? —

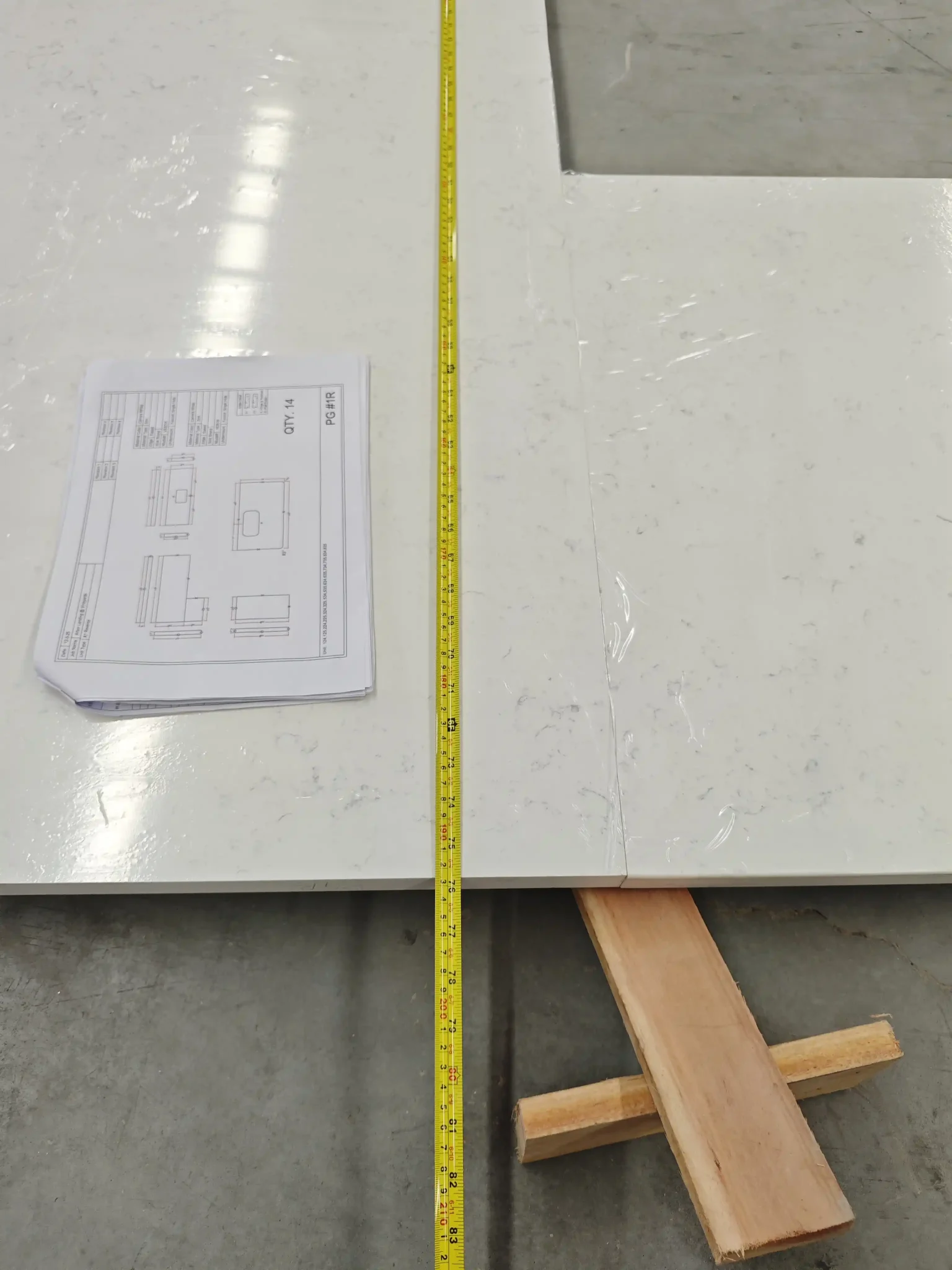

gqt risk hero card 1 1

Before Your Drawings Enter Production, We Standardize Them Again

gqt risk hero card 2 1

Inspection Report with Every Shipment

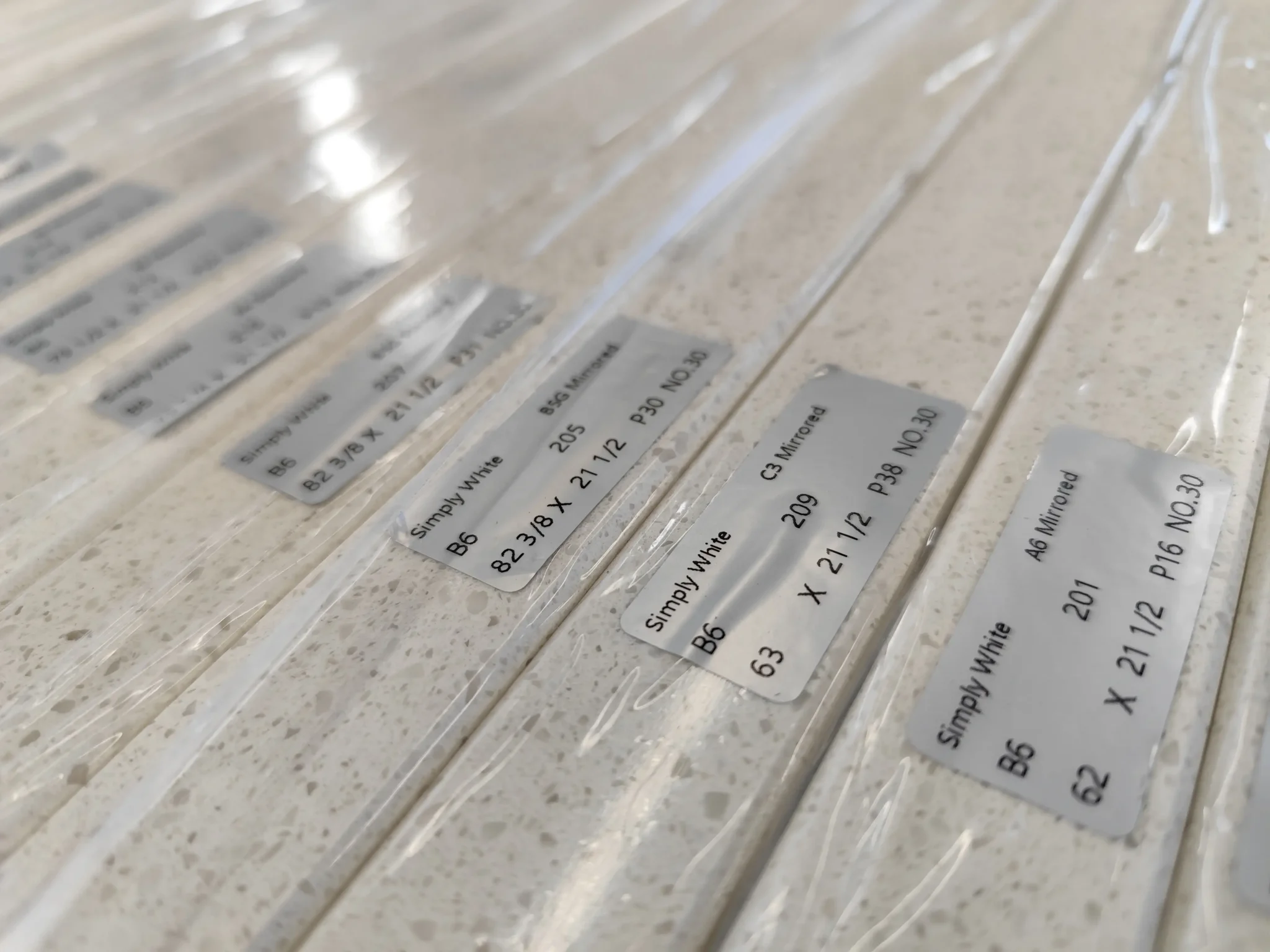

gqt risk hero card 3 1

Packaging and Container Loading

How Do We Help Reduce Your Risk Costs?

What happens when the wrong countertop supplier is chosen for a 200-unit apartment project? A wrong quote, incorrect dimensions, misplaced sink cutouts, poor packaging, delayed shipment, or no one to contact when something goes wrong. Every issue becomes a real cost: rework, downtime, customer complaints, and project delays.

Most of these risks come from weak process control. When a process has built-in checks, risk can be kept close to zero. When a process depends on people simply watching each other, risk can appear at every step.

Everything in this guide comes from our internal operating procedures. It covers quote preparation, drawing review, order confirmation, sink cutouts, change management, packing, container loading, and pre-shipment inspection. We are sharing these processes so you have a practical error-prevention checklist when evaluating suppliers.

Contents

01

Does the quote clearly state the stone, thickness, edge details, quantity, sink cutouts, accessories, and freight?

02

Before the order is placed, does the supplier confirm every detail in writing, or simply say, “No problem”?

03

When your drawings are incomplete, does the supplier simply build from them, or standardize and confirm them first?

04

If the order changes, is there a clear record of every change?

05

How will the packaging be organized? How will waterproof labels be marked? Can the jobsite start installation as soon as the shipment arrives?

06

Is there an inspection report before shipment? Are cutout dimensions based on actual measurements?

07

If something goes wrong, does the supplier have a clear response process and service commitment?

Chapter 1. Quoting: More Than a Price Sheet—A Preview of the Contract

Customer action

Send the project drawings and requirements to the supplier and request a quote.

Your concern

Missing items lead to extra charges later. An unclear quote can also result in the wrong product arriving on site.

Our approach

Every customer quote includes 10 required items. Each one can be checked:

01

Stone selection — Include actual product photos so you can confirm the pattern and color.

02

Thickness — 3 cm slabs are clearly marked in yellow for easy identification.

03

Edge details — Clearly describe the edge profile with photos or written codes.

04

Quantity — Show the total number of sets so you can quickly check for missing items.

05

Sink cutouts — State the number and location of each cutout based on the drawings.

06

Back-bolt holes and accessories — State clearly whether they are included.

07

Waterproofing and steel bars — Clearly state whether these are included where applicable for granite countertops.

08

Summary — Total square footage, total weight, total containers, total value, and average price.

09

Sink price — Provide a reference price for budgeting.

10

Door-to-door ocean freight — Provide a reference cost so you can estimate the true landed cost.

How we control risk

Every item is shown with both images and text. This avoids relying on verbal agreements. Quantity is shown as a total number of sets, not only as line items, making it easier to check on the spot.

What you get

A quote you can check item by item. It also becomes the checklist we use to align on your requirements. What is agreed during quoting is less likely to become an added cost or dispute later.

Below is a real project quote showing how the format works.

gqt risk image1

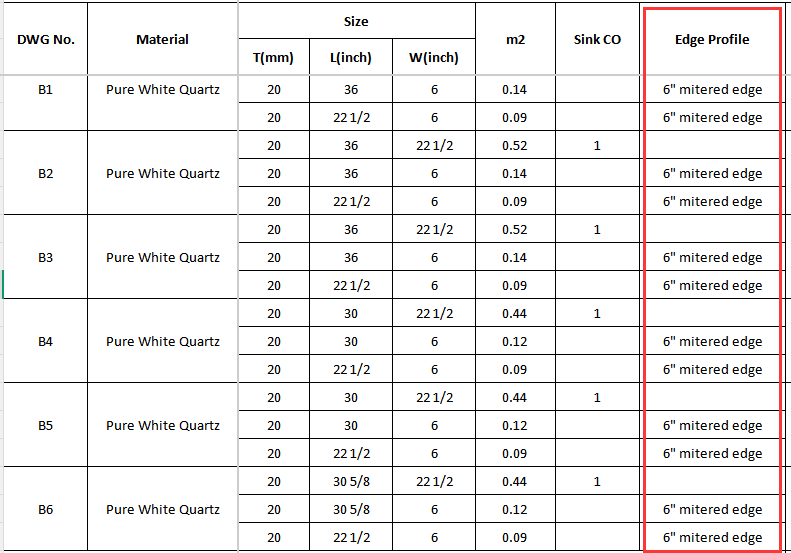

Figure 1-1. Real quote details: stone, slab dimensions, edge profile, and sink cutouts listed item by item.

gqt risk image2

Figure 1-2. Quote terms (Warm Tips): process scope, loading plan, payment terms, and lead-time commitment.

Chapter 2. Before Your Drawings Enter Production, We Standardize Them Again

Customer action

Send project drawings. They may come from a design firm or be hand sketches, so the level of detail can vary.

Your concern

Drawings may be missing the stone, thickness, edge profile, or sink cutout dimensions. If a supplier builds directly from incomplete drawings, you may pay for the mistake.

Our approach

Before an order is placed, our technical team reviews and standardizes every customer drawing and redraws it as a standard production drawing.

01

We complete the stone, thickness (including kitchen vs. bathroom and main slab vs. backsplash thickness), edge profile (such as EASED, MITERED, or LAMINATED), backsplash height, and other material details.

02

We complete the floor plan, elevations, cross-sections, and precise dimensions.

03

We standardize drawing numbers, page numbers, and scales for easier jobsite checks.

04

We add traceability information such as project name, address, color, and order number.

How we control risk

Standardization does not change your design. It removes unclear points before production starts. The shop builds from the approved production drawing. There is no “I thought you meant this.”

What you get

A production drawing that matches your design 100%, plus professional drawing standardization at no extra charge.

The two drawings below are from the same project. The left is the customer's original drawing. The right is our standardized production drawing.

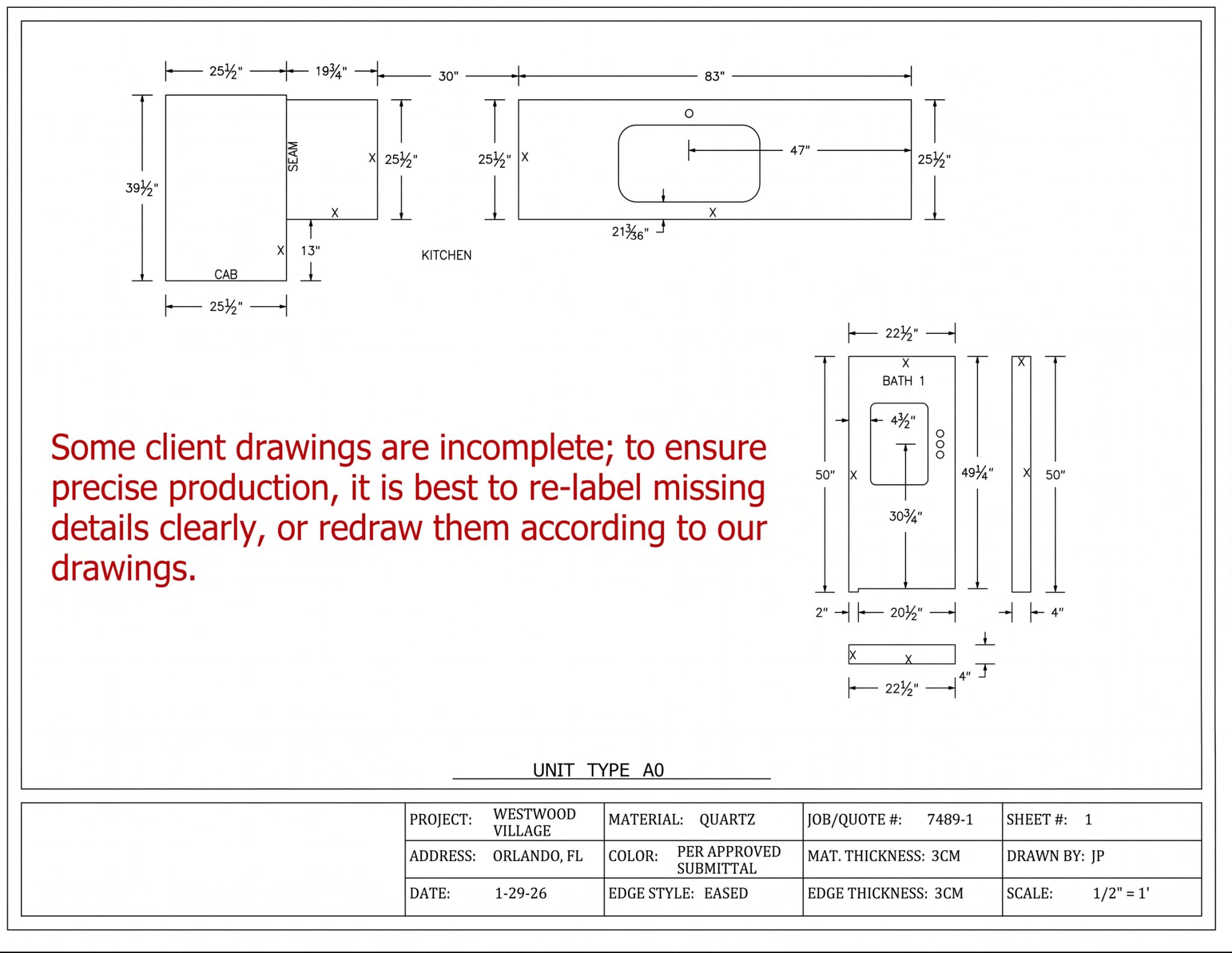

gqt risk image3

Figure 2-1. Customer's original drawing: incomplete information creates production risk.

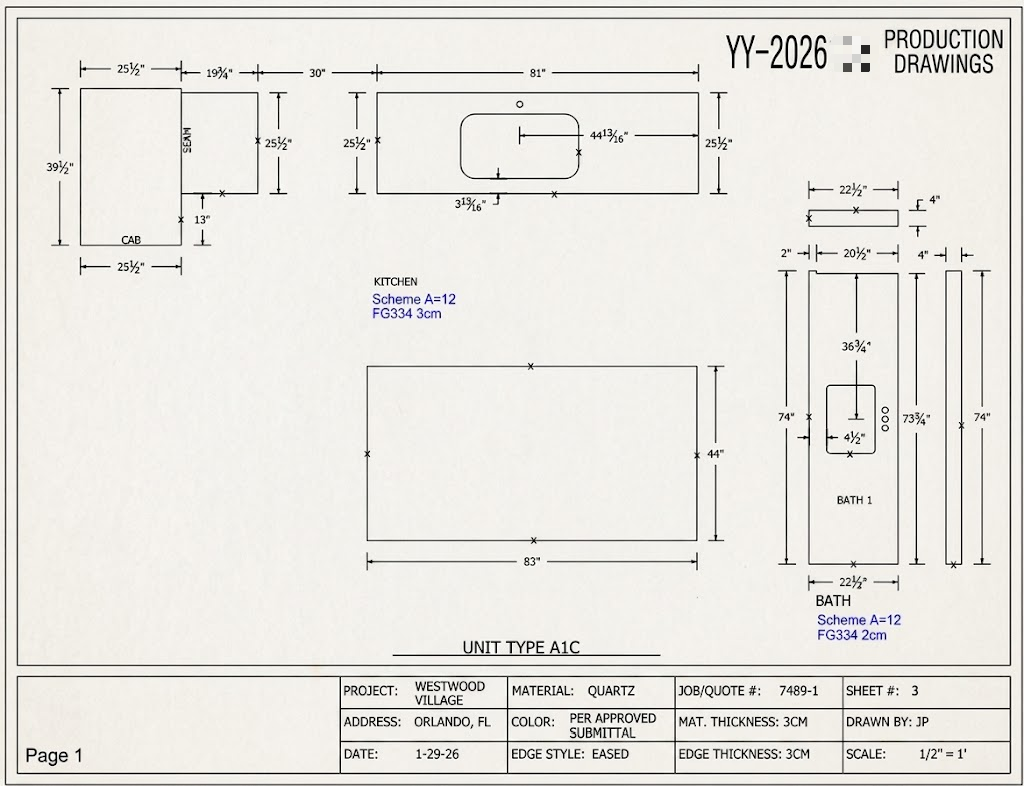

gqt risk image4

Figure 2-2. Standardized production drawing: materials, dimensions, edge profiles, and drawing numbers are clearly marked.

How We Read Your Drawings — Three Views, Nothing Missed

01

Floor Plan

overall countertop layout, total dimensions, sink cutouts, and faucet hole locations.

02

Elevation

backsplash height, end panels, fillers, toe kicks, and other vertical details.

03

Cross-Section

countertop thickness, edge profile, and component connections.

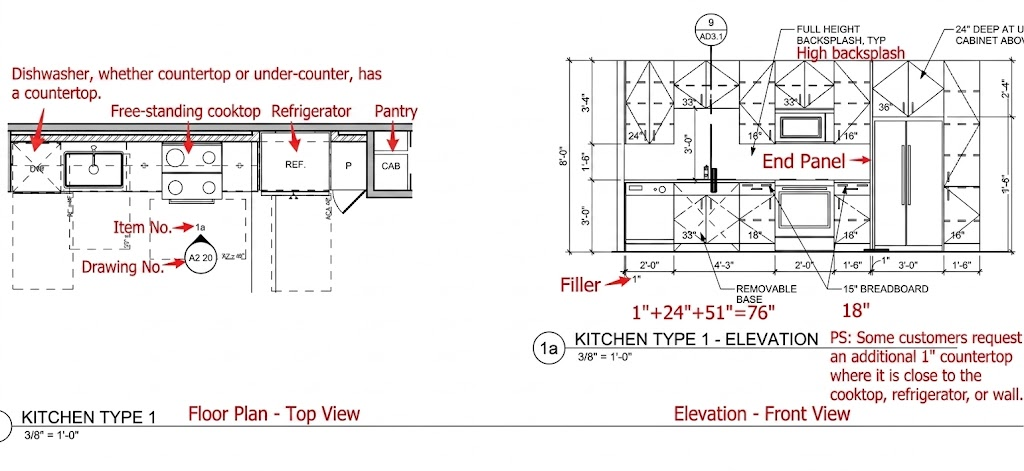

gqt risk image5

Figure 2-3. Kitchen countertop floor plan + elevation (with dishwasher, cooktop, refrigerator, and other locations marked).

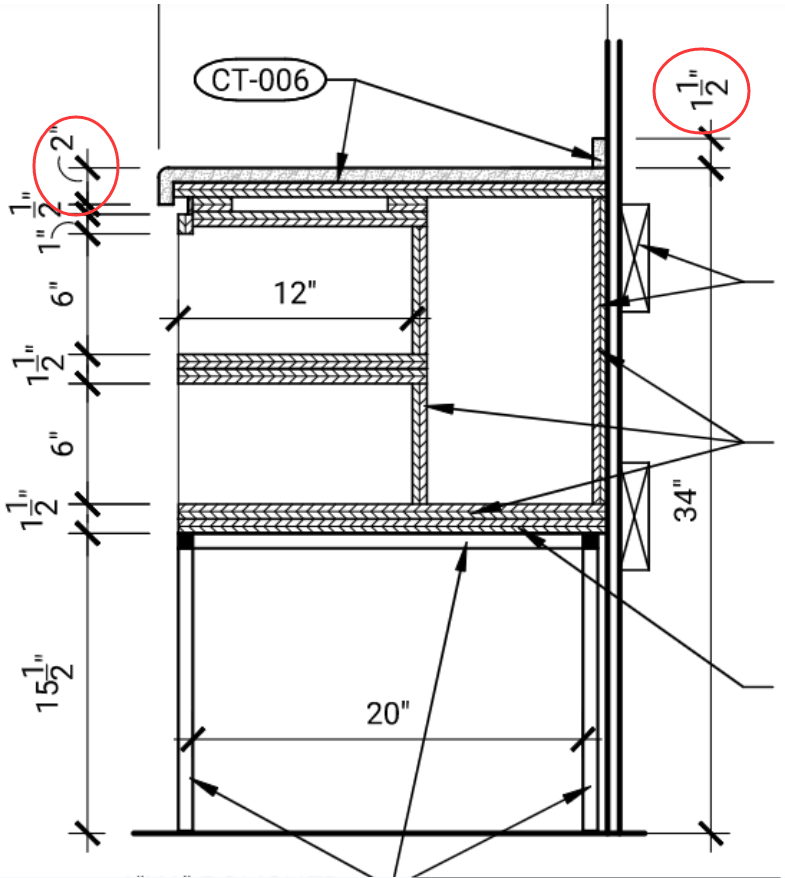

gqt risk image6

Figure 2-4. Countertop cross-section: thickness and edge details are clearly shown (“All edges eased, miter joint at seams”).

gqt risk image7

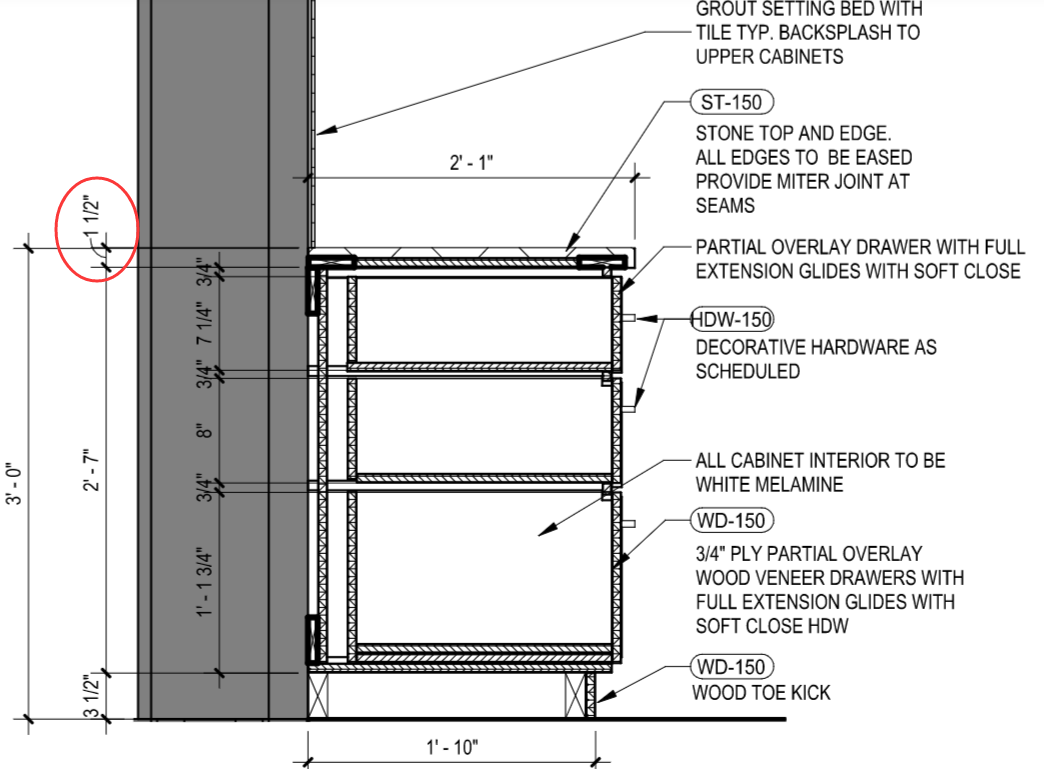

Figure 2-5. Cabinet and countertop cross-section: connection details.

gqt risk image8

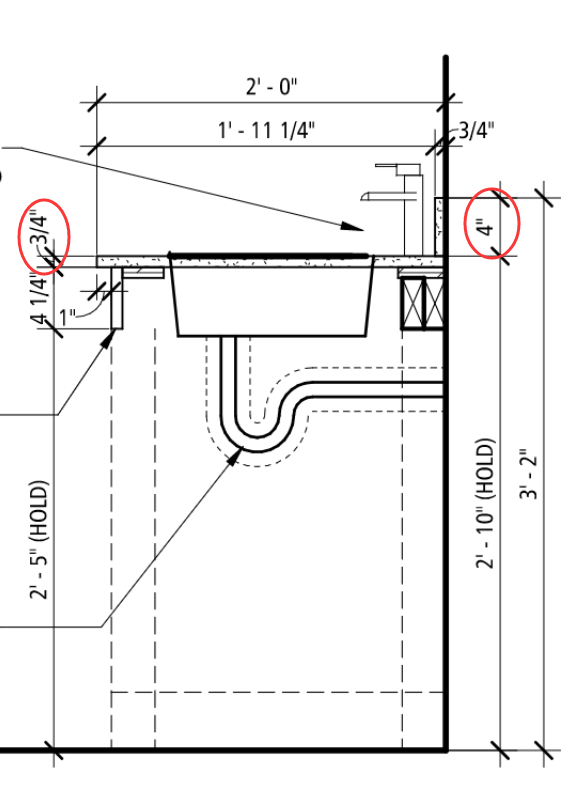

Figure 2-6. Bathroom vanity countertop and sink cutout cross-section.

Chapter 3. Before Ordering: 9 Details Confirmed in Writing—Never Just “No Problem”

Customer action

Confirm the order details and prepare to place the order.

Your concern

The color does not match. Faucet holes are in the wrong place. Sink setbacks are unclear. Packaging is not confirmed. Any missed detail can mean rework and delay.

Our approach

Before ordering, we put all key countertop details into a fixed checklist and confirm each item with you in writing:

01

Countertop dimensions — Carefully check every detail in the drawings.

02

Color matching — Confirm again before ordering that the color sample is approved and matched.

03

Faucet holes — Number, size, and spacing.

04

Edge profile — Confirm that the drawing symbol matches the actual edge detail.

05

Sink setback — Confirm the required setback with a drawing prepared by our logistics team.

06

Back-bolt holes — Confirm whether standard or special locations are required.

07

Packaging requirements — Pack by set or by size.

08

Shipping sequence — Directly affects factory scheduling and jobsite installation.

09

Installation date — Used to plan production and shipping backward from the required date.

How we control risk

These 9 items are not just a formality. Each one becomes a written confirmation and a production reference. We build what you approve. That is our error-prevention system.

What you get

Once the order is placed, the details are locked. Both sides have a clear understanding of the final result. There is no room for “I thought you knew.”

Chapter 4. Sink and Faucet Holes: Cut from Physical Templates, Never Estimated from Drawings

Customer action

Specify the sink and faucet models and include the hole requirements in the order.

Your concern

A wrong cutout can prevent the faucet from fitting or the sink from fitting. By the time the problem is found, the countertop may already be on site.

Faucet holes: Three common options for precise matching.

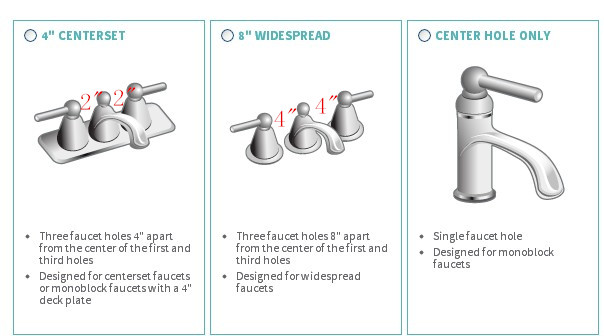

gqt risk image9

Figure 4-1. Three common faucet hole configurations: 4-inch centerset / 8-inch widespread / center hole only.

01

4" Centerset

The two outside holes are 4" apart, for centerset faucets.

02

8" Widespread

The two outside holes are 8" apart, for widespread faucets.

03

Center Hole Only

One hole for a single-hole faucet.

Sink cutouts: Cut from the actual sink template.

We follow one rule: sink cutouts are based on the actual sink template, not estimated only from drawing dimensions. The example below is from a real project and shows the exact dimensions for kitchen and bathroom sinks.

gqt risk image10

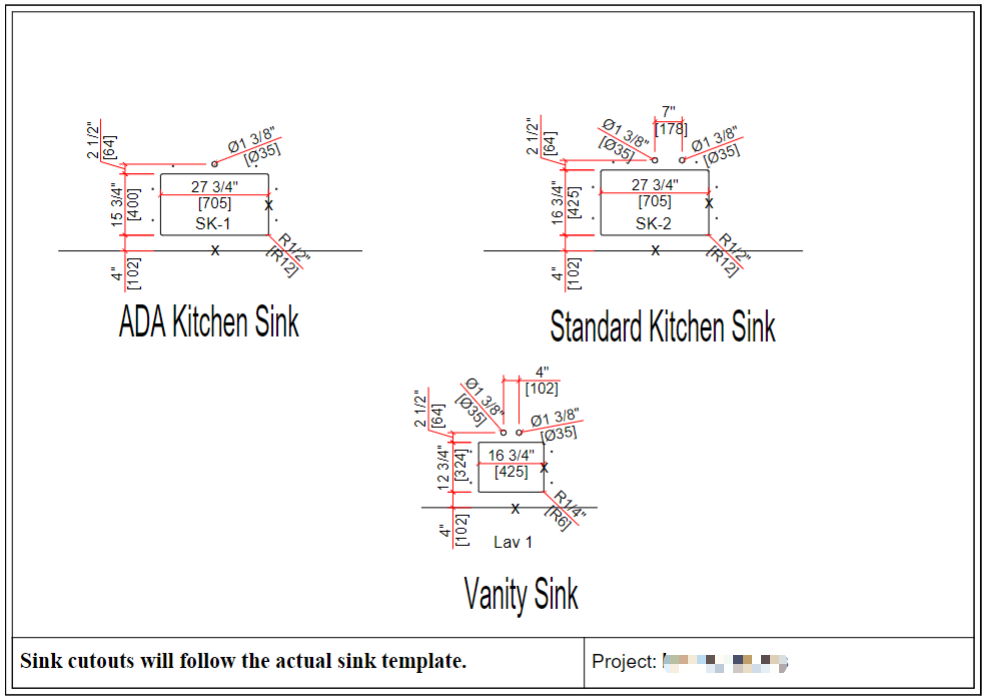

Figure 4-2. Kitchen and bathroom sink cutout dimensions (“Sink cutouts follow the actual sink template”).

gqt risk image11

Figure 4-3. ADA / standard / bathroom sink cutout options, with dimensions in both inches and millimeters.

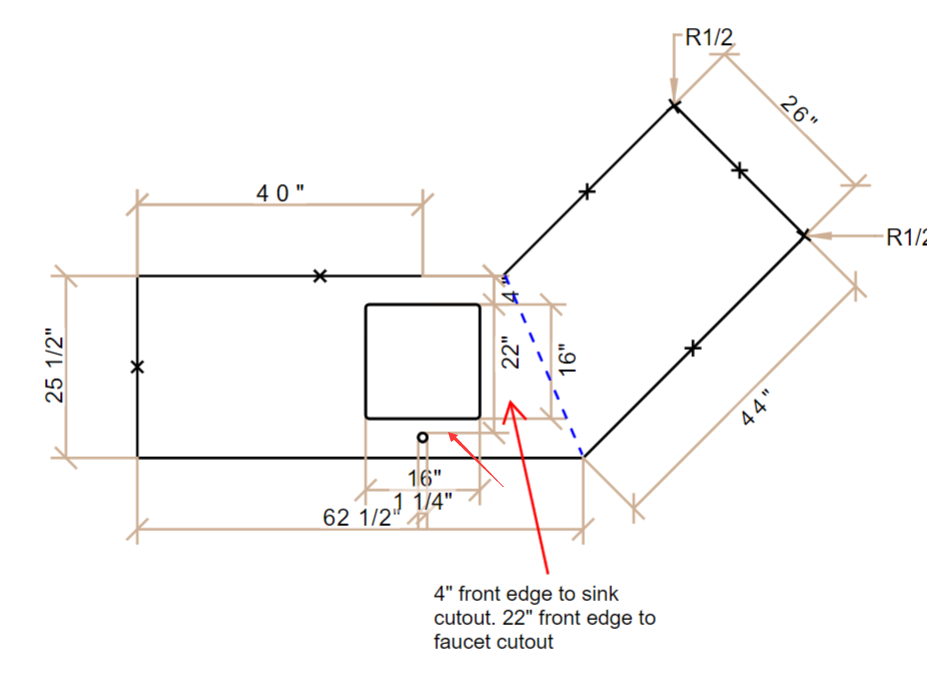

gqt risk image12

Figure 4-4. L-shaped countertop: precise distances from the front edge to the sink and faucet holes.

How we control risk

Confirm the hole layout on the CAD drawing first. Use the physical template during cutting. Show both units to reduce conversion errors.

What you get

The faucet and sink are ready to fit when the countertop arrives on site. No rework. No replacement slabs.

Chapter 5. Mid-Order Changes: Every Revision Is Recorded

Customer action

Change dimensions, replace a sink, adjust packaging, or change the delivery date during production. This is common on project countertops.

Your concern

A change may be missed and the shop may build from an old drawing. If something goes wrong, it may be unclear who changed what or when.

Our approach

Every detail update on an engineering order is recorded and used as a production reference.

How we control risk

Every change records what changed, why it changed, and when. The full history is traceable. Even after multiple revisions, the order stays organized because production follows only the latest approved version.

What you get

Many changes are manageable. Confusion is the real risk. We control the versions so you only need to approve the final one.

The three sets of screenshots below are from real project change records. They show how each revision is documented.

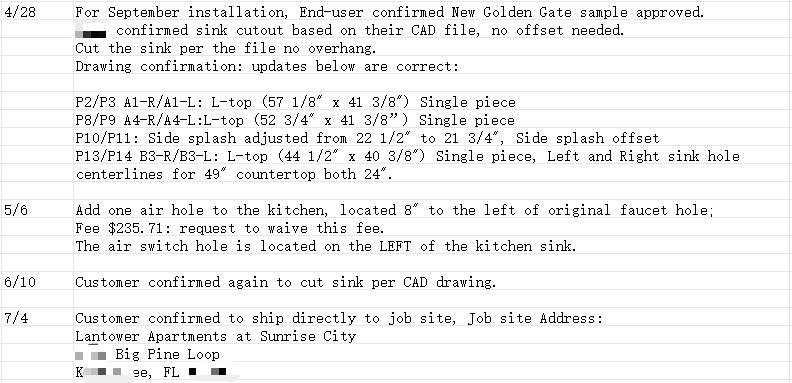

Figure 5-1. Change record 1: stone change, section adjustments, side backsplash setback, and added air holes.

Change record 1: stone change, section adjustments, side backsplash setback, and added air holes.

Figure 5-2. Change record 2: sink setback confirmation, shipment batch changes, pallet dimensions, and more.

Change record 2: sink setback confirmation, shipment batch changes, pallet dimensions, and more.

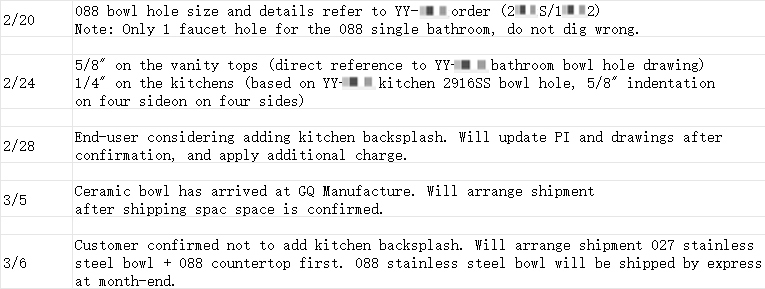

Figure 5-3. Change record 3: sink reference, faucet hole slotting, backsplash additions/removals, and more.

Change record 3: sink reference, faucet hole slotting, backsplash additions/removals, and more.

Document management: Each order has its own file set, with no version confusion.

Each project order has its own file set. Quotes (PI), sink CAD drawings, production drawings, production notes, and shipping sequence lists are stored by category. Updated drawings are named by date. Old versions are moved to an “Obsolete Files” folder so the shop does not use the wrong version.

gqt risk image17

Figure 5-4. Order file: quote / shipping sequence / sink CAD / production drawings / notes.

gqt risk image18

Figure 5-5. Drawings organized by version and date.

gqt risk image19

Figure 5-6. Complete file set for a large project.

gqt risk image21

Figure 5-8. Obsolete files and customer drawings stored separately.

gqt risk image20

Figure 5-7. Files archived by date, with obsolete versions kept separately.

Chapter 6. Packaging and Container Loading: Organized by Building and Floor for “Unbox and Install”

Customer action

Wait for shipment, then distribute the countertops to each floor and unit after delivery.

Your concern

Hundreds of pieces arrive mixed together. The jobsite team cannot find the right pieces for each building, and installation stops.

Our approach

We follow your specified packaging plan when you have one. Otherwise, we use a tiered packing system:

01

First, group by building.

02

Then, divide by floor.

03

Within each floor, separate pieces by size (high and low pieces packed separately).

04

Keep kitchen pieces separate from bathroom pieces.

05

Mark the order number, piece number, and panel type on the outside of each package.

How we control risk

Our packing plan considers both transport safety and container efficiency. If your requested packaging would increase the number of containers, we will explain it first and offer a more efficient option. You keep the choice. We take responsibility for the risk.

What you get

Pieces can be distributed and installed by label on the day they arrive. No second sorting is needed.

Container loading in practice:

gqt risk image22

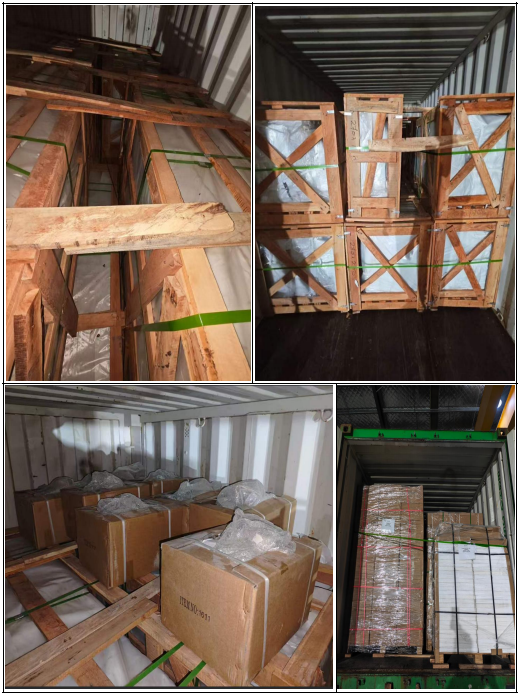

Figure 6-1. Container loading with wooden-frame support and carton packaging.

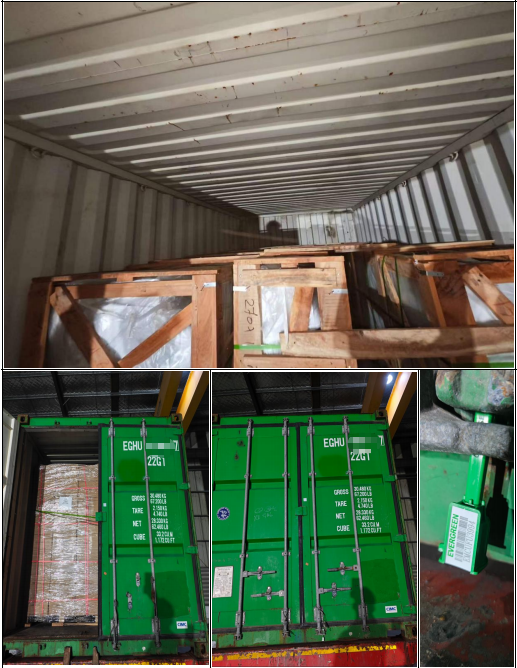

gqt risk image23

Figure 6-2. Sealed container: container number, net weight, and volume clearly recorded for full tracking.

01

Large and heavy pieces

A-frame wooden racks + steel straps.

02

Medium and small countertops

direct carton packing + steel-strap reinforcement.

03

After the container is sealed, we label it with the container number, net weight, volume, and other required information. The shipment remains traceable throughout transit.

Chapter 7. Inspection Report with Every Shipment: Measured Dimensions + Visual Inspection

Customer action

Receive the shipment and arrange inspection.

Your concern

Dimension errors or surface defects are discovered only after delivery, leading to claims and installation delays.

Our approach

Every countertop batch is inspected before shipment, with an inspection report provided:

Real inspection records:

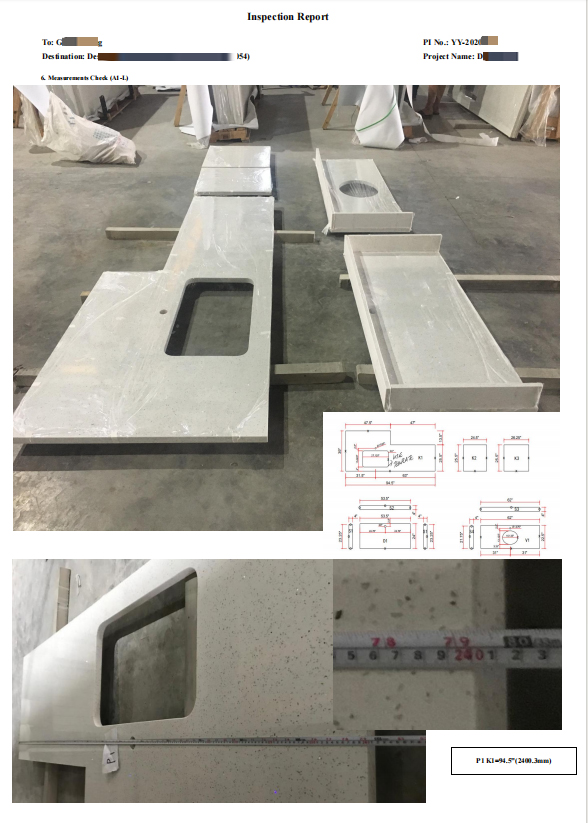

gqt risk image25

Figure 7-1. Measured sink cutout dimensions checked against CAD drawings.

gqt risk image24

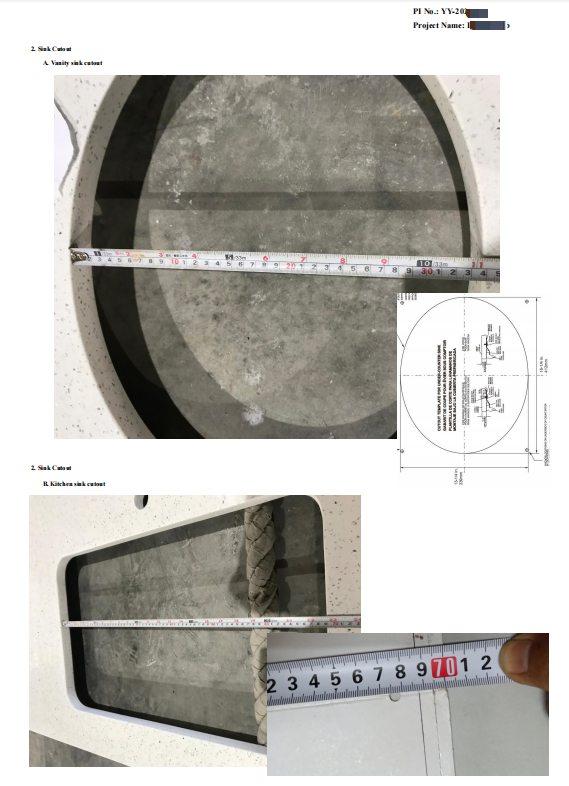

Figure 7-2. Overall dimension and appearance inspection report.

01

Sink cutout dimensions — Measured with a tape and checked item by item against the CAD drawings.

02

Overall dimensions — Length, width, and thickness checked against the cross-section drawings.

03

Appearance — Pieces are laid out and photographed. Surface and edge details are checked.

How we control risk

Inspection is completed at the factory, so issues are resolved before loading. We do not let questionable pieces leave the shop. That is what “ready to ship” means to us.

What you get

An inspection report travels with the shipment. You can inspect on receipt without spending extra time on third-party remeasurement.

Chapter 8. Evaluating a Supplier — Look at Actual Production

The most direct way to evaluate a supplier is to see the production floor. The photos below are from real project production at Grand Quartz's factory in Chonburi, Thailand. Every piece shown has gone through the processes described in the first seven chapters.

gqt risk image26

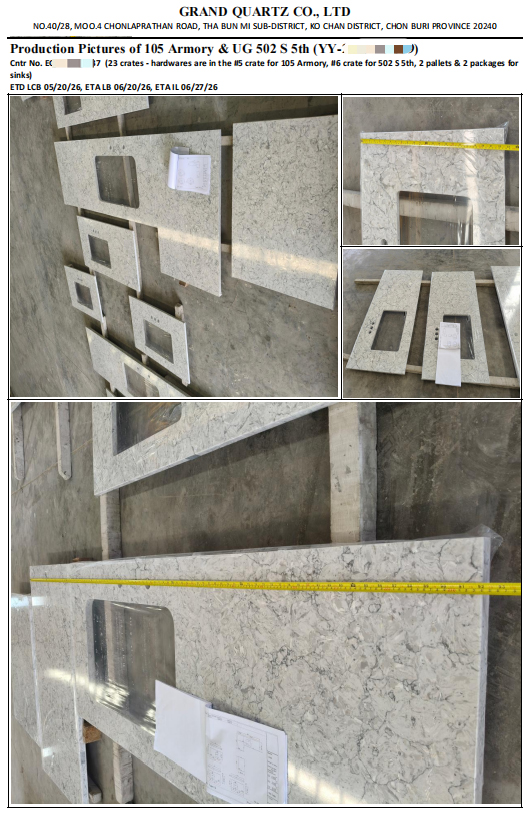

Figure 8-1. Quartz countertop production: slabs neatly stored with complete QC labels.

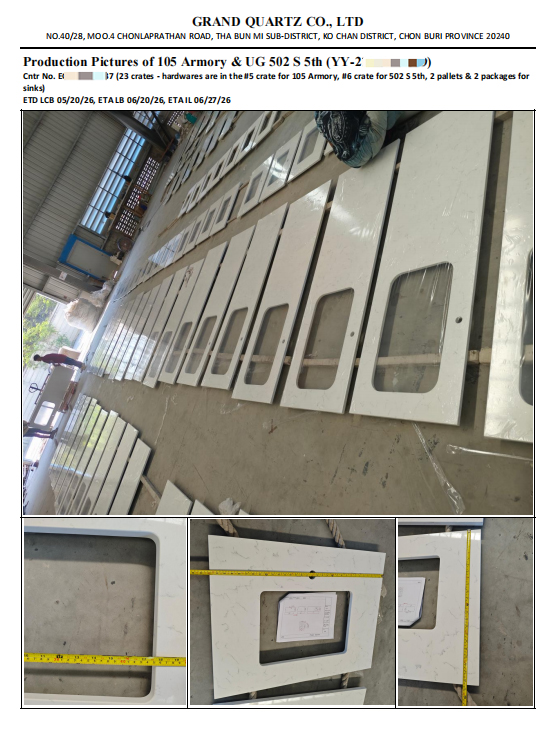

gqt risk image27

Figure 8-2. Quartz countertop production: sink cutouts and edge work completed, ready for packing and shipment.

Color consistency in batch projects — One project, one color, consistent output

One of the biggest concerns with project countertops is that the sample looks different from the bulk order. The two real project drawings below show consistent stone, composite construction, and edge treatment across different units in the same project, helping keep the countertops consistent throughout the building.

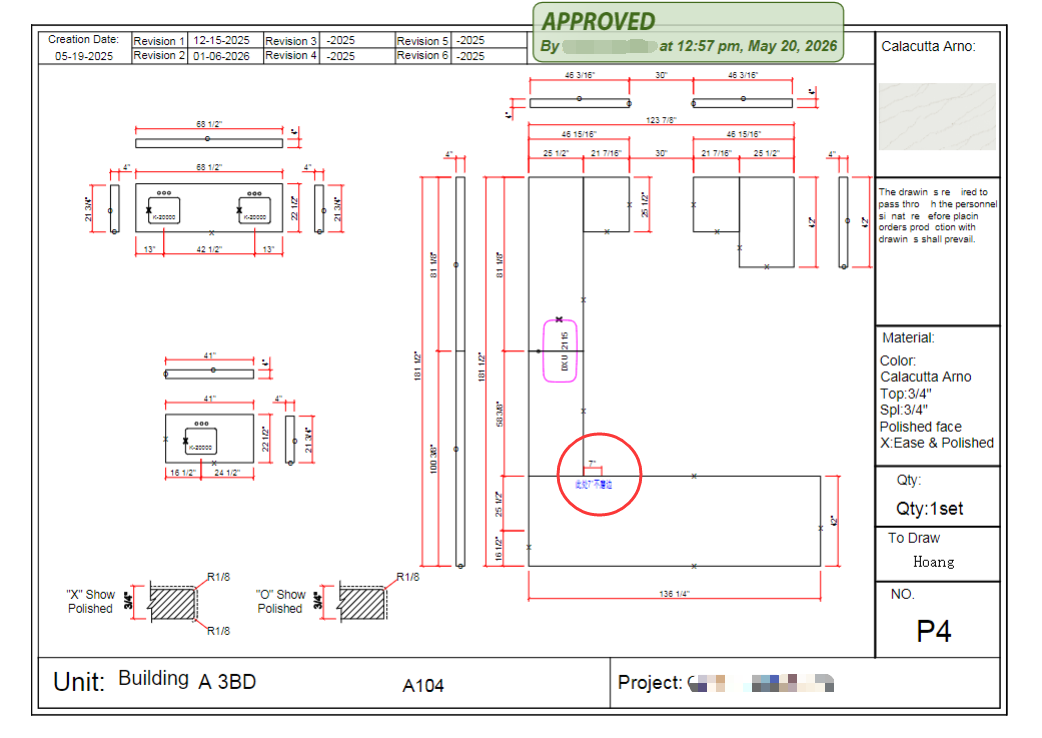

gqt risk image28

Figure 8-3. Calacatta Arno quartz project drawing (3/4" + 3/4" laminated construction, X Ease & Polished edge).

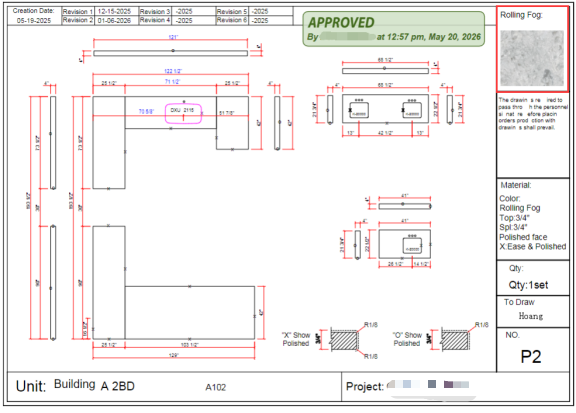

gqt risk image29

Figure 8-4. Rolling Fog quartz project drawing (consistent color across the same project).

Our Commitment

Everything may go well, but what if something really goes wrong? Will the supplier still be there?

37 years of stone manufacturing experience

Grand Quartz Technology has been in the stone industry for 37 years, with a factory in Chonburi, Thailand.

International certifications

NSF certification for food-contact safety and SGS quality testing.

Full process records

Quotes, drawings, order confirmations, change records, and inspection reports are all traceable.

Dedicated contact

Each order has a clear point of contact and a process for handling issues.

24-hour response

We provide a proposed solution within 24 hours after receiving a reported issue.

Dedicated contact

We provide ocean freight references, container loading, and shipment tracking.
